Site Preparation — Foundation Build Process

The 13-Step Site Preparation & Foundation Process

From utility notification to framing-ready subfloor, this is the complete ground-up process used to prepare the site, protect drainage, control moisture, and build the structural floor system before the walls ever go up.

Shed Footprint 10×12 Standard backyard example
Prepared Pad 14×16 Min. 2' clearance all sides
Gravel Base #57 Limestone 6" minimum, consolidated
Moisture 10 Mil Barrier Overlapped and taped
Foundation 6×6 PT Beams Four 12' beams
Floor Joists 2×6 PT 16" OC with blocking
Subfloor 3/4" PT Ground contact plywood
The Ground-Up Sequence

Built In Order, Verified At Every Layer

A strong backyard structure starts long before the walls are framed. The following sequence shows how the ground is cleared, shaped, stabilized, drained, protected from moisture, and prepared for a framing-ready floor system.

How To Follow This Process Each Step Begins With The Construction Image. The Explanation Follows Directly Beneath It.

As you move through the sequence, first review the image for the step being shown. The written section immediately below that image identifies the step, explains what happens, why it matters, and the field standard used on the build.

Begin Below With Step 01 — 811 Utility Notification

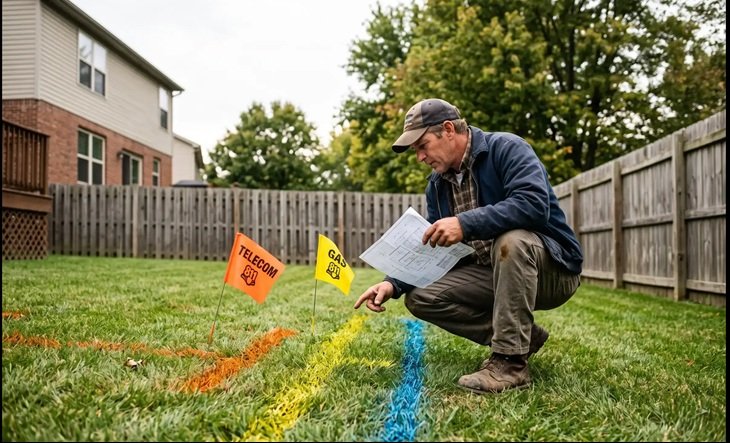

Step 01 — Before Any Work Begins

Underground Utility Notification — 811 Call Before You Dig

What Happens

A single call or online request to 811 notifies registered utility operators. Utility companies locate and mark underground infrastructure using standardized color-coded paint and flags. Red: electric. Yellow: gas. Blue: water. Green: sewer. Orange: telecom. Work close to marked lines requires extra caution and may require hand digging only.

Think of this like checking for buried danger before you break ground. The site may look clear from the surface, but gas, electric, water, sewer, and communication lines can be hidden below the work area. The foundation process does not begin until underground utilities are identified and respected.
Why It Matters

A gas line strike is a life-threatening emergency. An electric line strike is potentially fatal. The 811 process protects the homeowner, the crew, the property, and underground infrastructure.

Field Standard
  • 811 contact made before any ground disturbance
  • Applies to all three Tri-State jurisdictions: Ohio, Kentucky, and Indiana
  • All utility marks received and waiting period satisfied before work begins
  • Hand digging only where required near marked utility lines
  • No stake, flag, equipment, or ground disturbance before this step is complete
Next Step Step 02 — Site Clearing & Demo

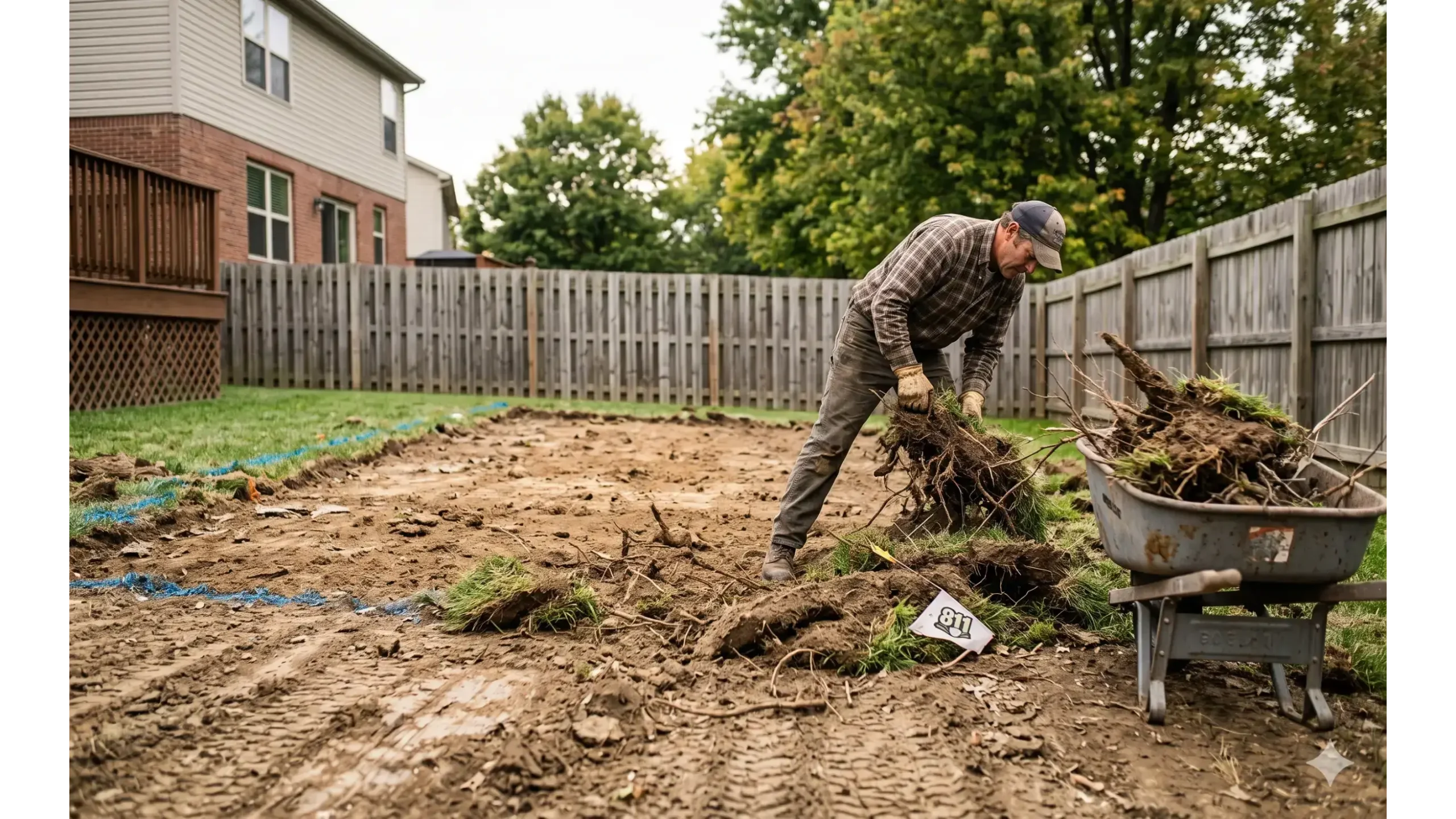

Step 02 — Site Clearing

Clear The Site — Every Organic Material, Every Obstruction, Gone

What Happens

The entire proposed building area is cleared to bare ground. All vegetation, brush, debris, and surface obstructions are removed. If an existing shed or outbuilding occupies the site, a complete demolition and removal is coordinated before any foundation work begins. Nothing is buried, covered, or worked around.

Think of this like pulling weeds before you plant a garden — anything left behind that can rot, shift, or harbor moisture becomes a long-term problem underneath the foundation. There is no correcting a contaminated base after the structure is in place.
Field Standard
  • All surface debris, brush, and organic material removed from the full work zone
  • Existing structures dismantled and removed — no buried debris left behind
  • Disposal completed prior to any layout or excavation work
  • Work zone access confirmed for equipment
Next Step Step 03 — Layout & Elevation
Step 03 — Layout & Elevation

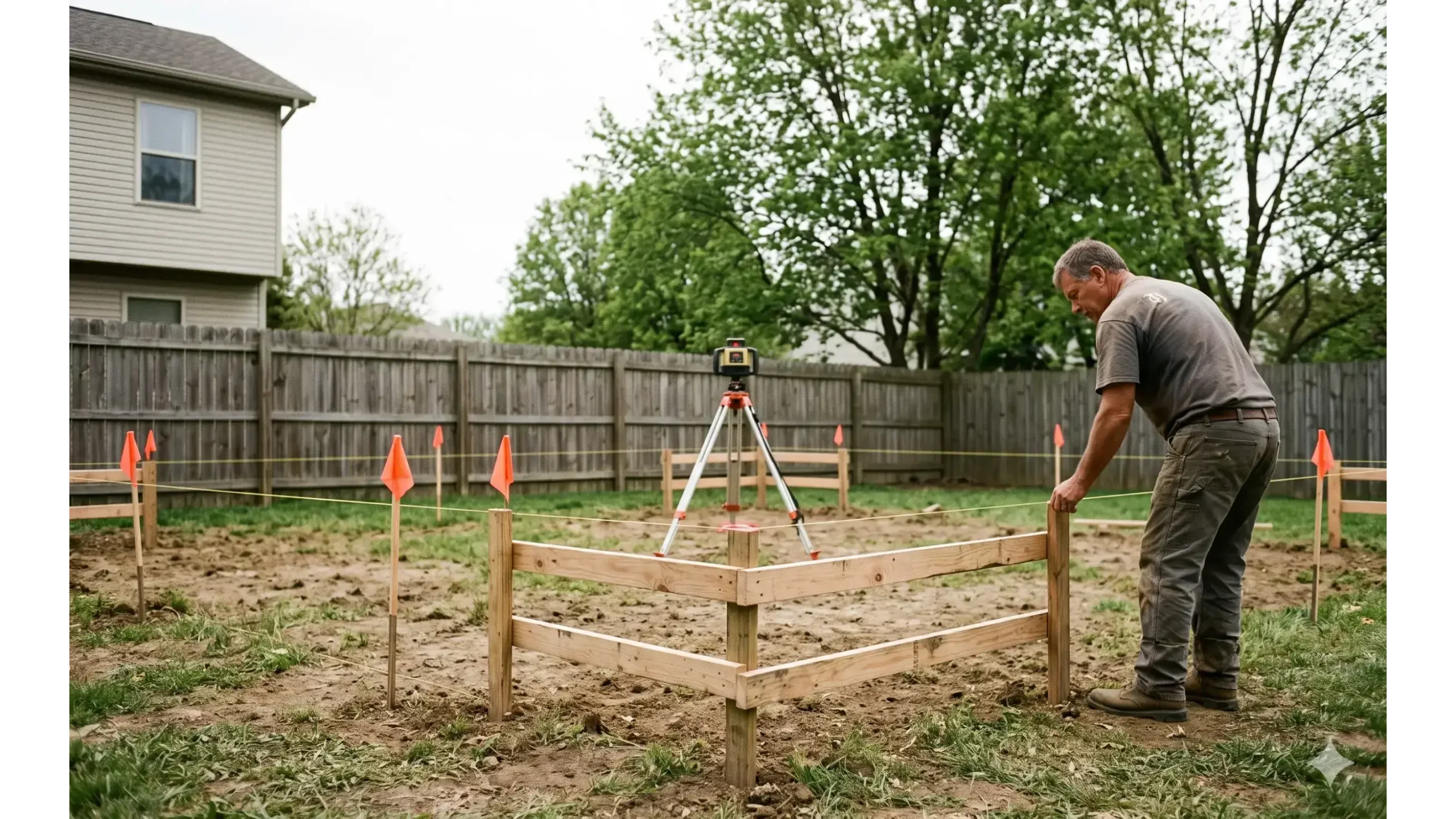

Stakes, Flags & Batter Boards — The Laser-Level Layout That Controls Everything Below

What Happens

Two separate reference systems are established simultaneously. The 14×16 rough pad boundary — extending a minimum of 2 feet beyond the shed on all four sides — is staked and flagged. Batter boards are set beyond each building corner, outside the excavation zone.

String lines between batter boards allow exact building lines and finish floor elevation to be re-established at any point during construction, even after the ground is disturbed. A rotary laser level is used to confirm and record the planned finish floor elevation before excavation begins.

Think of batter boards and laser-established elevations the way a surgeon thinks about positioning before an operation — once cutting begins, the reference points must remain fixed and trustworthy. If elevation or squareness is wrong here, every step below inherits that error.
Field Standard
  • 14×16 minimum rough pad for a 10×12 shed — 2' clearance all sides
  • Corner stakes and surveyor flags placed at all four rough pad corners
  • Batter boards set and anchored beyond each building corner
  • Finish floor elevation established from site drainage and confirmed with rotary laser
  • All elevations recorded before excavation begins
Next Step Step 04 — Excavation
A luxury Grand Appalachian wooden garden shed featuring natural cedar shake siding, a shed dormer with upper transom windows, double carriage doors, and a flower box in a landscaped backyard

Step 04 — Excavation

6-Inch Minimum Excavation — Nothing Organic Remains Beneath The Pad

What Happens

All sod, root systems, organic topsoil, and biologically active material are excavated from the full 14×16 rough pad area to a minimum depth of 6 inches. In Greater Cincinnati's clay-heavy soils, excavation may extend to 8 or 10 inches to reach stable inorganic mineral soil. Sod and clean topsoil are stockpiled for reuse in finish grading around the completed building.

Organic material — grass, roots, and topsoil — never stops decomposing and compressing. Leaving it beneath a foundation is like building on a slow-motion sinkhole. The 6" minimum helps ensure the pad bears on stable mineral subgrade, not material that will continue to settle for years.
Field Standard
  • Minimum 6" excavation across the full 14×16 rough pad area
  • All sod, roots, stumps, and organic topsoil removed — no exceptions
  • Cut depth adjusted deeper as needed for clay-heavy soils
  • Sod and clean topsoil stockpiled for landscape finish grading reuse
  • Excavation lines maintained consistent with batter board string references
Next Step Step 05 — Subgrade Inspection & Compaction
A luxury Grand Appalachian wooden garden shed featuring natural cedar shake siding, a shed dormer with upper transom windows, double carriage doors, and a flower box in a landscaped backyard
Step 05 — Subgrade Inspection & Compaction

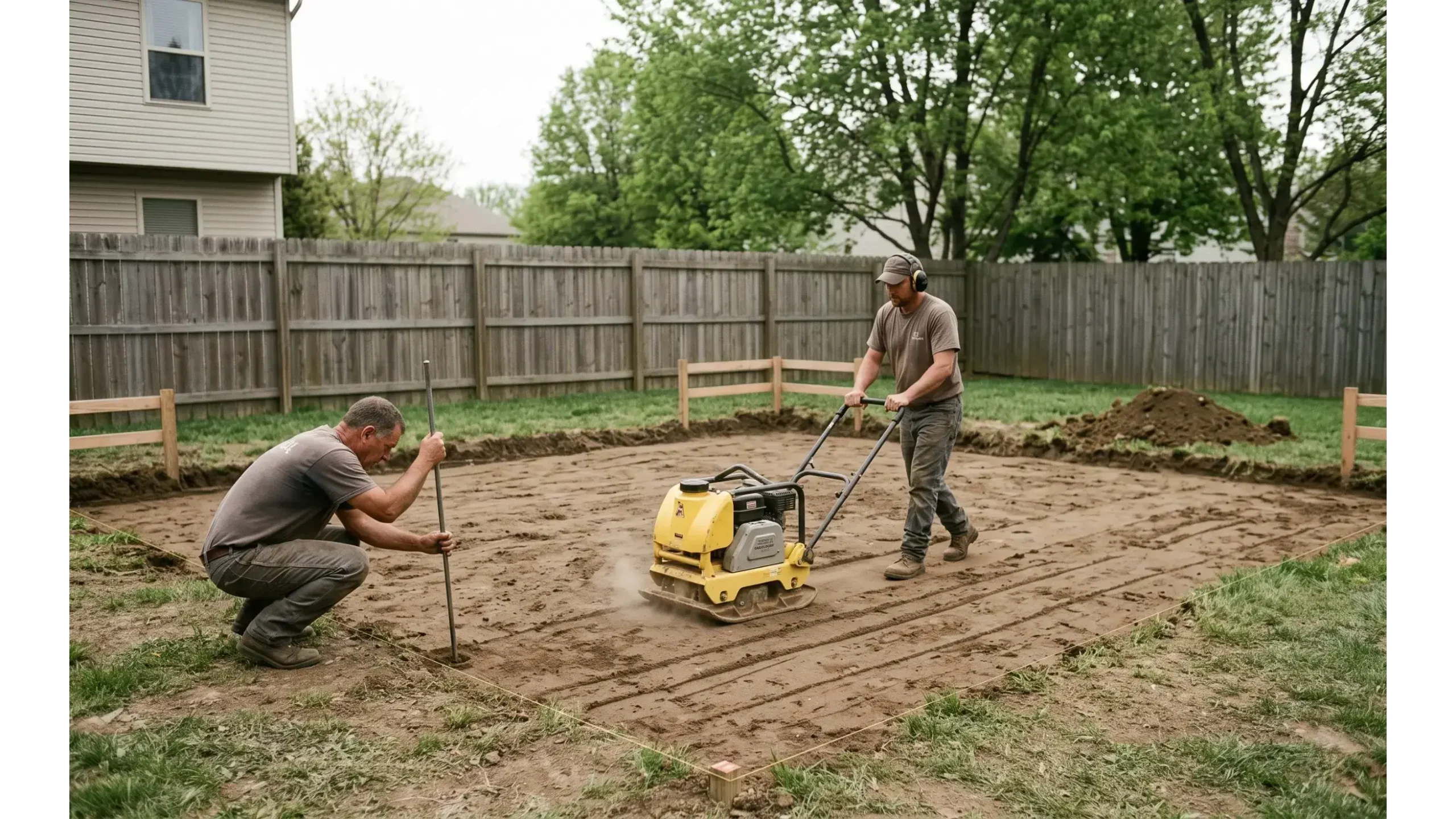

Inspect, Regrade & Compact The Native Subgrade

What Happens

After excavation, the exposed subgrade is inspected for soft spots, loose fill, trapped roots, wet pockets, and unstable soil. Any unsuitable material is removed and replaced or reworked before the base layers continue. The subgrade is then regraded for positive drainage and compacted in overlapping passes with a plate compactor.

This step creates the firm, consistent bearing surface that supports the fabric, stone base, moisture barrier, foundation beams, and floor system above it. The goal is not simply to make the ground look flat. The goal is to create a stable prepared subgrade that does not pump, rut, settle, or hold water beneath the finished building.

Think of the subgrade like the bottom layer of a road. Gravel, beams, and floor framing can only perform as well as the ground below them. If the subgrade is soft, loose, or poorly drained, every layer above it inherits the weakness.
Field Standard
  • Exposed subgrade inspected for soft areas, loose fill, roots, wet pockets, and unstable soil
  • Unsuitable material removed, replaced, or reworked before base installation continues
  • Subgrade shaped to support positive drainage away from the building footprint
  • Plate compactor used in overlapping passes across the prepared pad area
  • Final surface checked for stability before geotextile fabric is installed

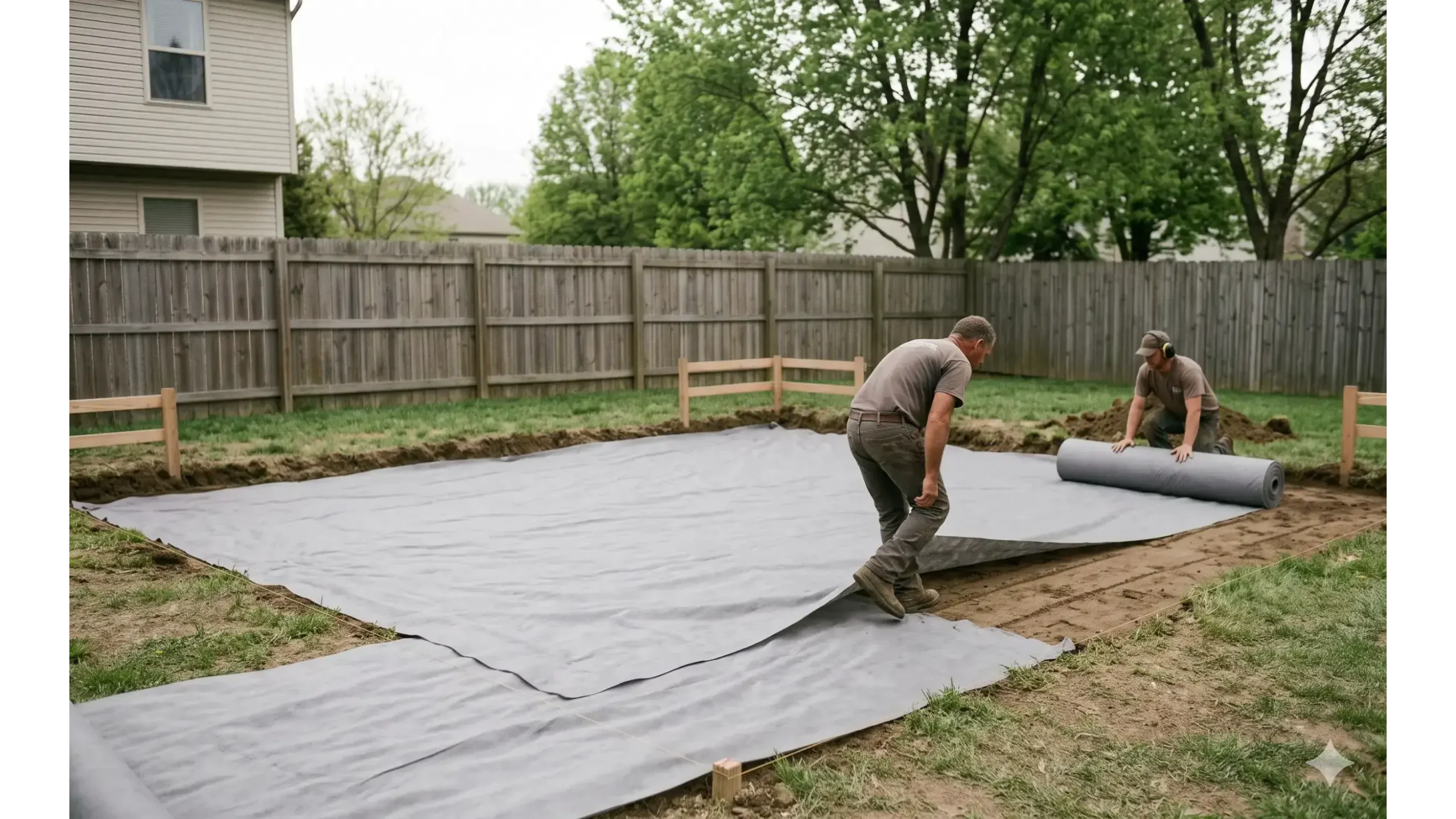

Next Step Step 06 — Geotextile Stabilization Fabric
Grand Appalachian cedar board and batten shed with black shingle roof, front dormer, double wood doors, barn sash windows, and autumn woodland setting.
Step 06 — Geotextile Stabilization Fabric

Separation Fabric — Keeping Stone Clean, Stable & Structurally Useful

What Happens

Commercial geotextile stabilization fabric is rolled out across the prepared 14×16 pad area before any stone is placed. The fabric separates the compacted soil subgrade from the crushed stone base above it, helping prevent the stone from sinking into clay, mud, or softened soil over time.

Fabric seams are overlapped, pulled flat, and extended across the full prepared pad area so the gravel base remains clean and separated from the native soil below. The fabric is installed before stone placement, not after.

Think of geotextile fabric like a filter and separator between two different layers. Without it, clean stone can slowly disappear into soft soil, especially in wet clay conditions. Once stone mixes with mud, it no longer drains or supports the same way.
Field Standard
  • Commercial geotextile stabilization fabric installed across the full prepared pad area
  • Fabric placed directly over the compacted subgrade before stone is installed
  • Seams overlapped approximately 24 inches where multiple fabric runs are required
  • Fabric pulled flat and extended to support the full gravel base footprint
  • No stone placed directly on clay, mud, roots, or exposed organic material

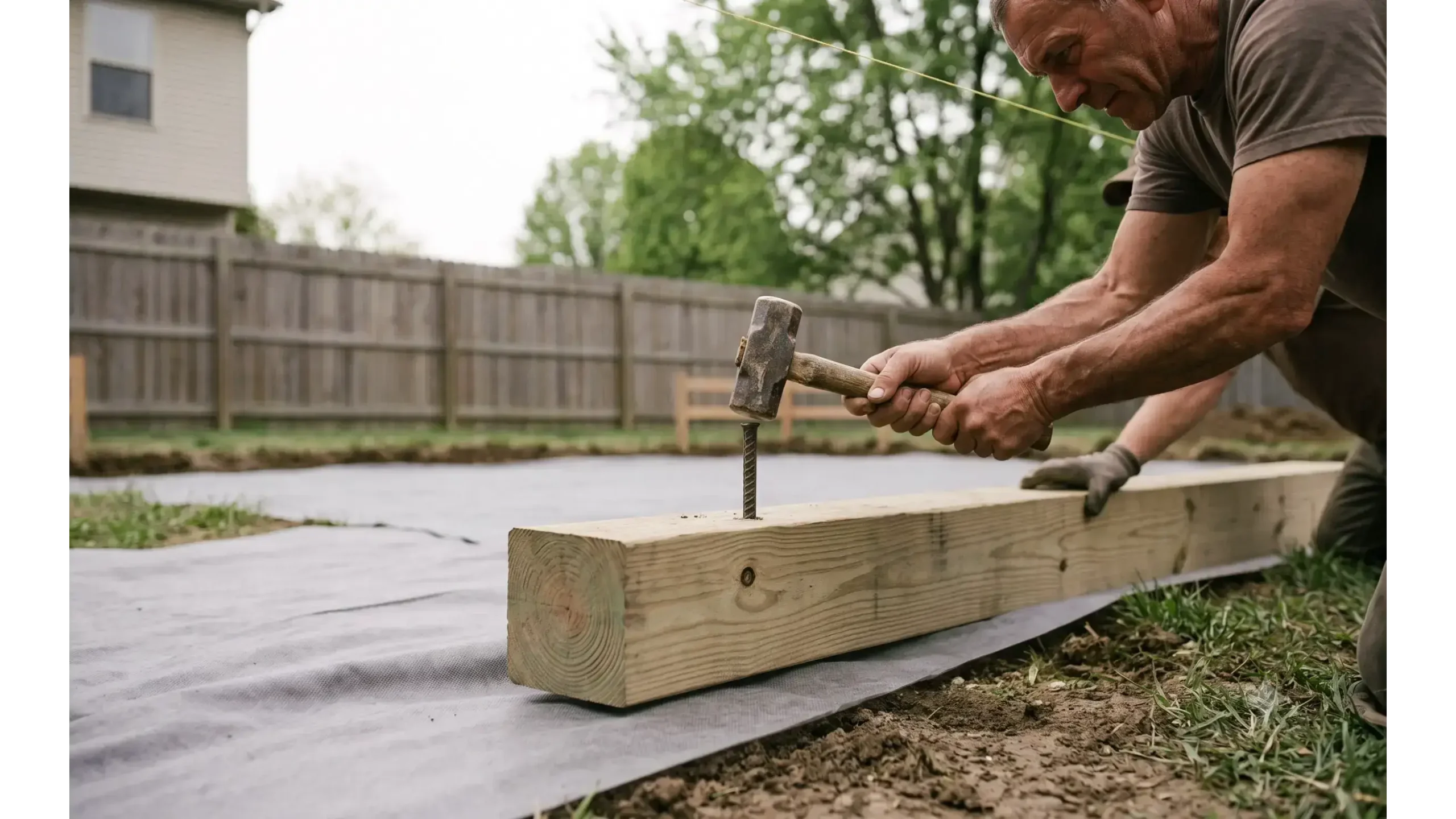

Next Step Step 07 — Perimeter Containment
Grand Appalachian cedar board and batten shed with black shingle roof, front dormer, double wood doors, barn sash windows, and autumn woodland setting.
Step 07 — Perimeter Containment

Pressure-Treated Perimeter Containment — Holding The Stone Base In Place

What Happens

Pressure-treated perimeter containment timbers are installed around the full prepared pad area before the stone base is placed. The containment frame helps define the gravel pad boundary, holds the crushed stone in position, protects the clean edge of the foundation base, and helps prevent gravel from migrating into the surrounding yard over time.

The perimeter is set to the planned pad layout and checked against the batter board references. Where site conditions allow, the timbers are secured with driven rebar stakes to help maintain alignment and resist movement during stone placement, grading, and long-term use.

Think of the perimeter containment like the frame around a concrete form or the edge restraint around a paver patio. Without a defined edge, stone can spread, flatten, and drift outward. A contained base holds its shape and keeps the foundation layers working together.
Field Standard
  • Pressure-treated perimeter containment installed around the full prepared pad area
  • Pad boundary checked against layout stakes, batter boards, and planned shed position
  • Containment timbers set before stone placement begins
  • Rebar stakes used where site conditions allow to help resist movement
  • Containment set to preserve a clean, stable edge for the gravel base

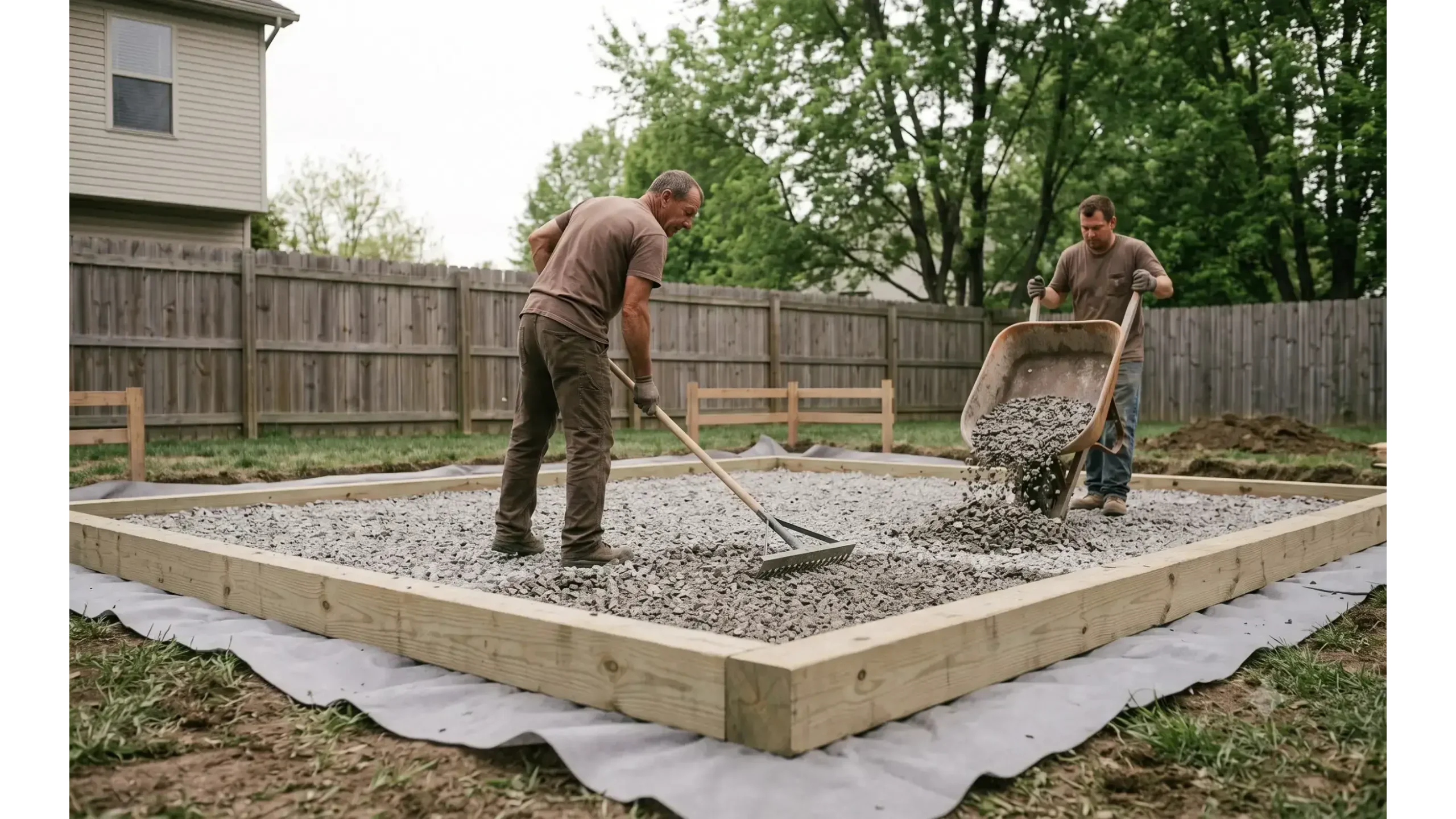

Next Step Step 08 — #57 Limestone Placement
Grand Appalachian cedar board and batten shed with black shingle roof, front dormer, double wood doors, barn sash windows, and autumn woodland setting.
Step 08 — #57 Limestone Placement

6-Inch #57 Washed Limestone Base — Drainage, Bearing & Stability

What Happens

A minimum 6-inch layer of #57 washed limestone, or a comparable clean angular stone, is placed across the full prepared pad area inside the perimeter containment. The stone is spread evenly over the geotextile fabric and raked to the planned elevation before final consolidation.

The clean angular stone creates a stable, free-draining base beneath the moisture barrier, foundation beams, and floor system. Because the stone is washed and open-graded, water can move through the base instead of collecting directly beneath the building.

Think of the limestone base like the gravel bed under a driveway or patio. It spreads load, improves drainage, and creates a stable layer between the building and the soil below. Thin stone, dirty stone, or rounded stone does not perform the same way.
Field Standard
  • Minimum 6" #57 washed limestone or comparable clean angular stone
  • Stone placed across the full prepared pad area inside perimeter containment
  • Stone installed over geotextile fabric, not directly over clay or organic soil
  • Base spread evenly and raked to planned elevation before consolidation
  • Open-graded stone selected to support drainage beneath the structure

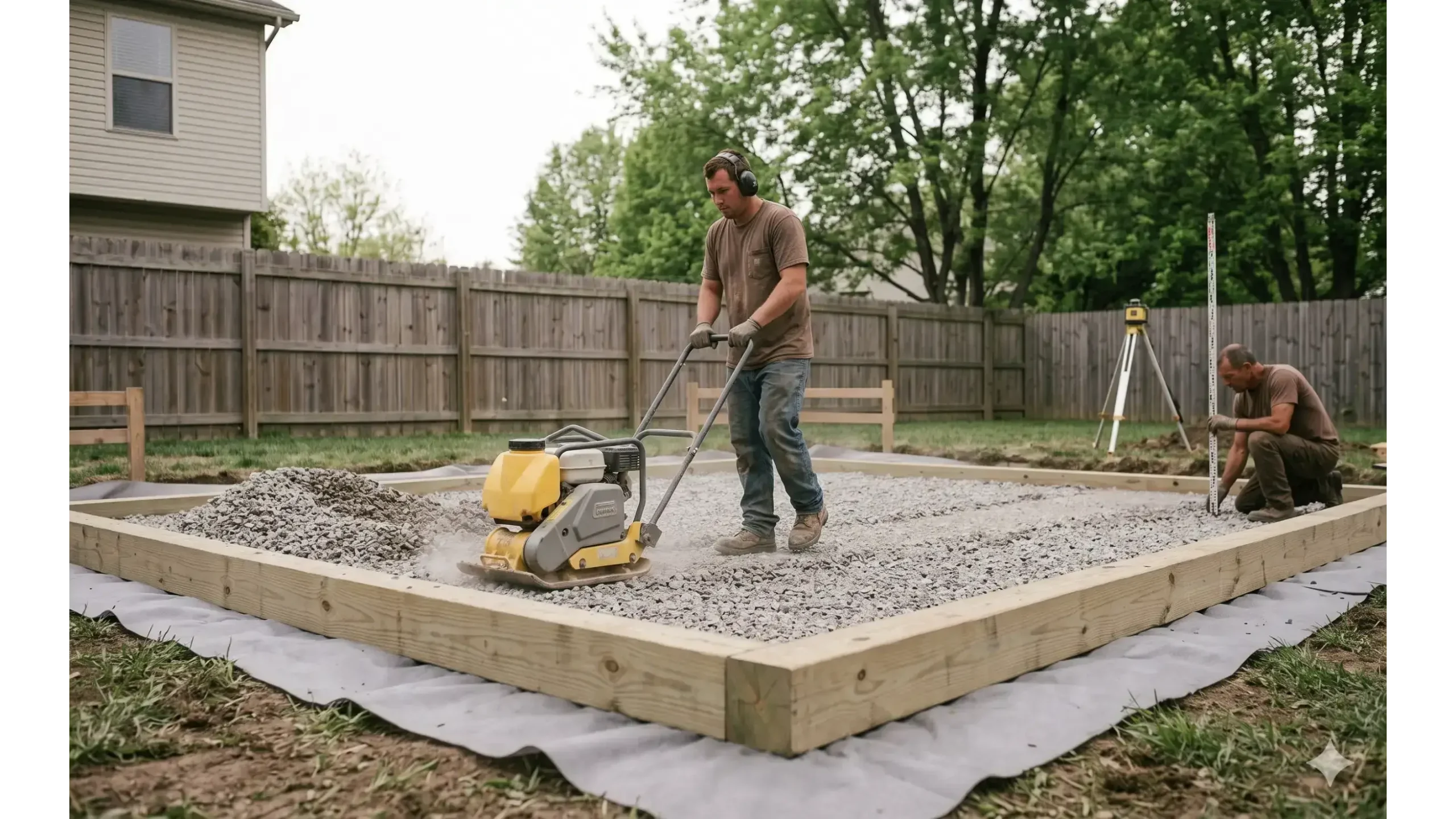

Next Step Step 09 — Gravel Consolidation
Red Grand Appalachian backyard shed with shed dormer, black shingle roof, double barn doors, transom windows, and autumn wooded landscape.
Step 09 — Gravel Consolidation

Level, Seat & Consolidate The Stone Base Before Moisture Protection Begins

What Happens

The #57 washed limestone base is leveled, checked against the planned elevation, and consolidated across the full prepared pad area. The stone is raked, adjusted, and seated so the base is even, stable, and ready to receive the moisture barrier and foundation beam layout.

Clean angular stone does not compact like soil or crusher fines. Instead, the goal is to settle, seat, and stabilize the stone so the pieces interlock, high spots are corrected, low areas are filled, and the finished surface supports the layers above without shifting or rocking.

Think of this step like setting the gravel bed before laying pavers. The stone needs to be even, seated, and stable before anything valuable goes on top. If the base is loose, uneven, or full of high spots, the moisture barrier, beams, and floor system will inherit those problems.
Field Standard
  • #57 washed limestone leveled across the full prepared pad area
  • Stone checked against planned elevation before the moisture barrier is placed
  • High areas raked down and low areas filled to create a consistent bearing surface
  • Clean angular stone seated and consolidated, not treated like compacted soil
  • Finished stone base confirmed stable before moisture protection begins
Next Step Step 10 — 10-Mil Moisture Barrier
Red Grand Appalachian backyard shed with shed dormer, black shingle roof, double barn doors, transom windows, and autumn wooded landscape.
Step 10 — 10-Mil Moisture Barrier

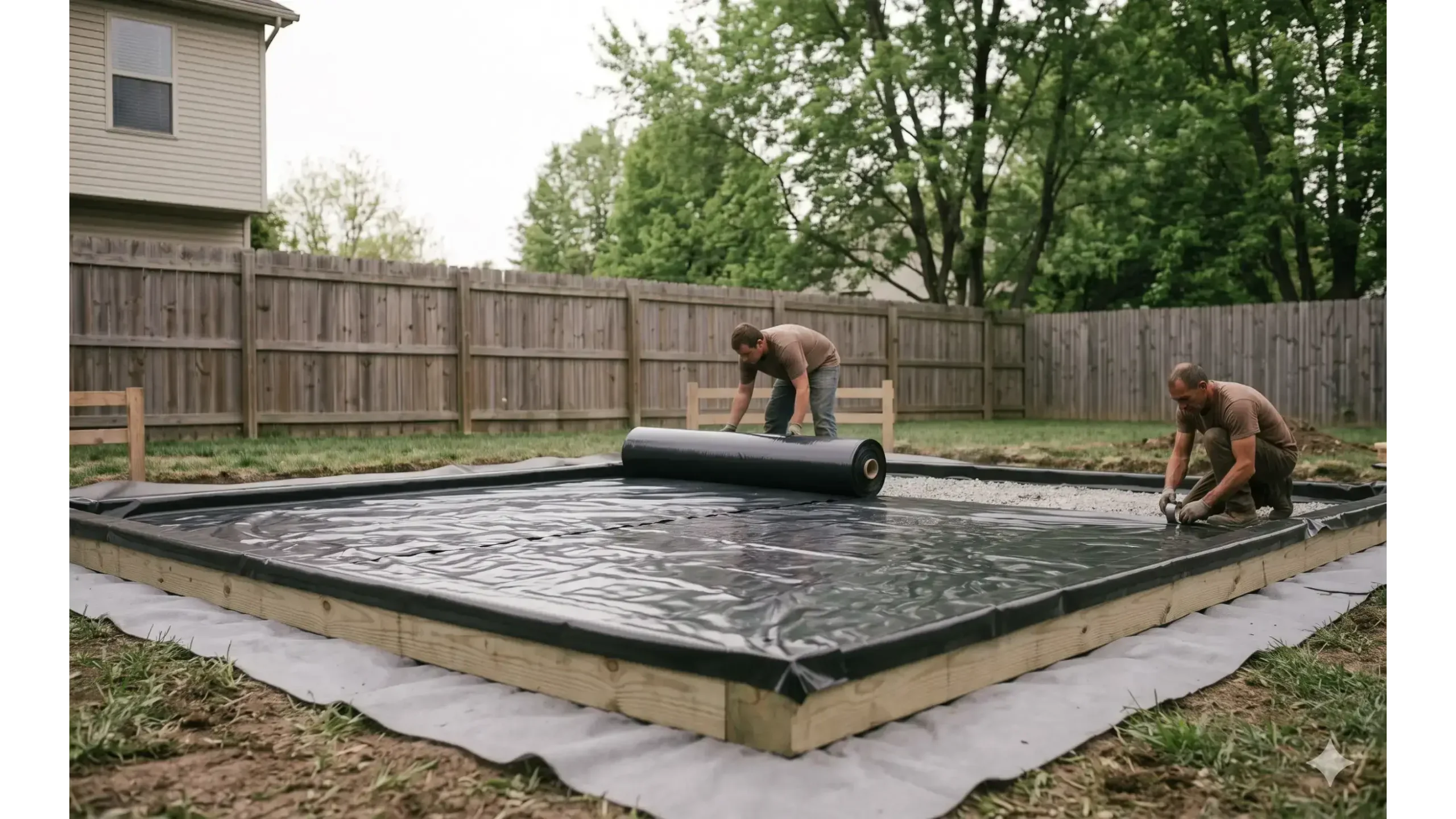

Moisture Barrier Over Stone — Separating The Wood Foundation From Ground Moisture

What Happens

A 10-mil polyethylene moisture barrier is placed over the consolidated stone base before the foundation beams are set. The barrier is laid flat across the prepared pad area, with seams overlapped and taped where multiple sheets are required.

This layer helps reduce ground moisture exposure beneath the structural floor system. It is installed after the stone base is prepared and before the 6×6 pressure-treated foundation beams are positioned.

Think of the moisture barrier like a protective raincoat beneath the building. The gravel base manages drainage, but the barrier adds another layer of separation between ground moisture and the wood floor structure above.
Field Standard
  • 10-mil polyethylene moisture barrier installed over the consolidated stone base
  • Barrier placed before 6×6 foundation beams are set
  • Sheets laid flat across the prepared pad area
  • Seams overlapped and taped where multiple sheets are required
  • Barrier protected from unnecessary punctures during beam placement and framing layout
Next Step Step 11 — 6×6 Foundation Beams
Appalachian barn shed with Duratemp board and batten siding, dark trim, gambrel roof, double barn doors, side firewood shelter, and Adirondack chair.
Step 11 — 6×6 Foundation Beams

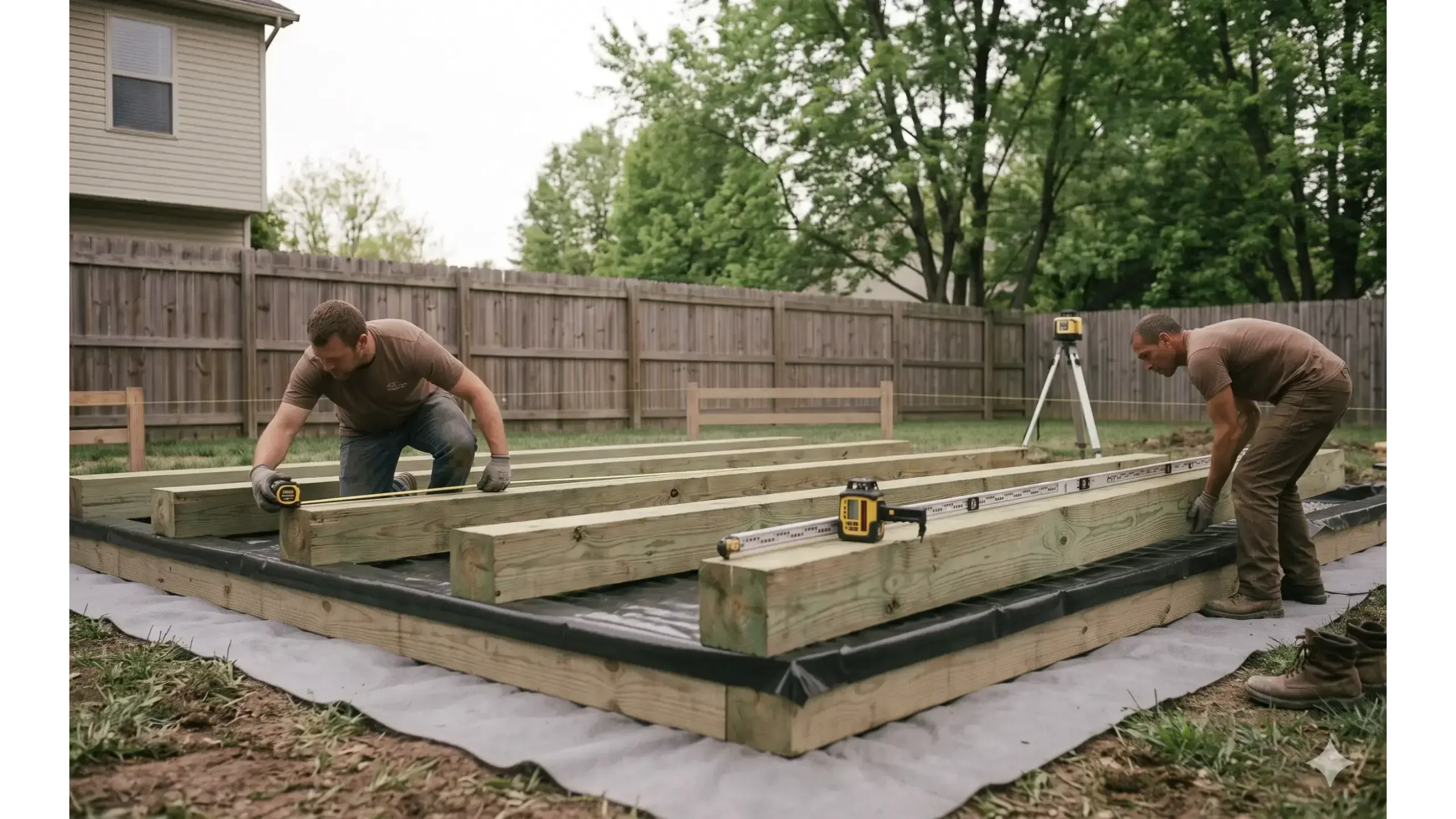

Five equally spaced 6×6 Ground-Contact Foundation Beams — The Structural Base That Carries The Floor

What Happens

Five equally spaced 6×6×12' ground-contact pressure-treated foundation beams are set on top of the moisture barrier and aligned with the actual 10×12 building footprint. The beams run in the 12-foot direction and are spaced evenly across the 10-foot width to provide continuous support beneath the floor framing.

Each beam is checked for straightness, alignment, spacing, and elevation. The beam system must be level, co-planar, and properly positioned before the 2×6 floor joist system is installed above it.

Think of the 6×6 beams like the main rails under a bridge deck. The floor joists and subfloor above can only stay flat and stable if the beams below are straight, evenly spaced, and sitting in the same plane.
Field Standard
  • Five equally spaced 6×6×12' ground-contact pressure-treated foundation beams used for the 10×12 footprint
  • Beams installed on top of the 10-mil moisture barrier
  • Beams run parallel with the 12-foot building direction
  • Beams spaced evenly across the 10-foot building width
  • Beam layout checked for straightness, spacing, elevation, and co-planar bearing before floor framing begins
Next Step Step 12 — Floor Joist System
Appalachian barn shed with Duratemp board and batten siding, dark trim, gambrel roof, double barn doors, side firewood shelter, and Adirondack chair.
Step 12 — Floor Joist System

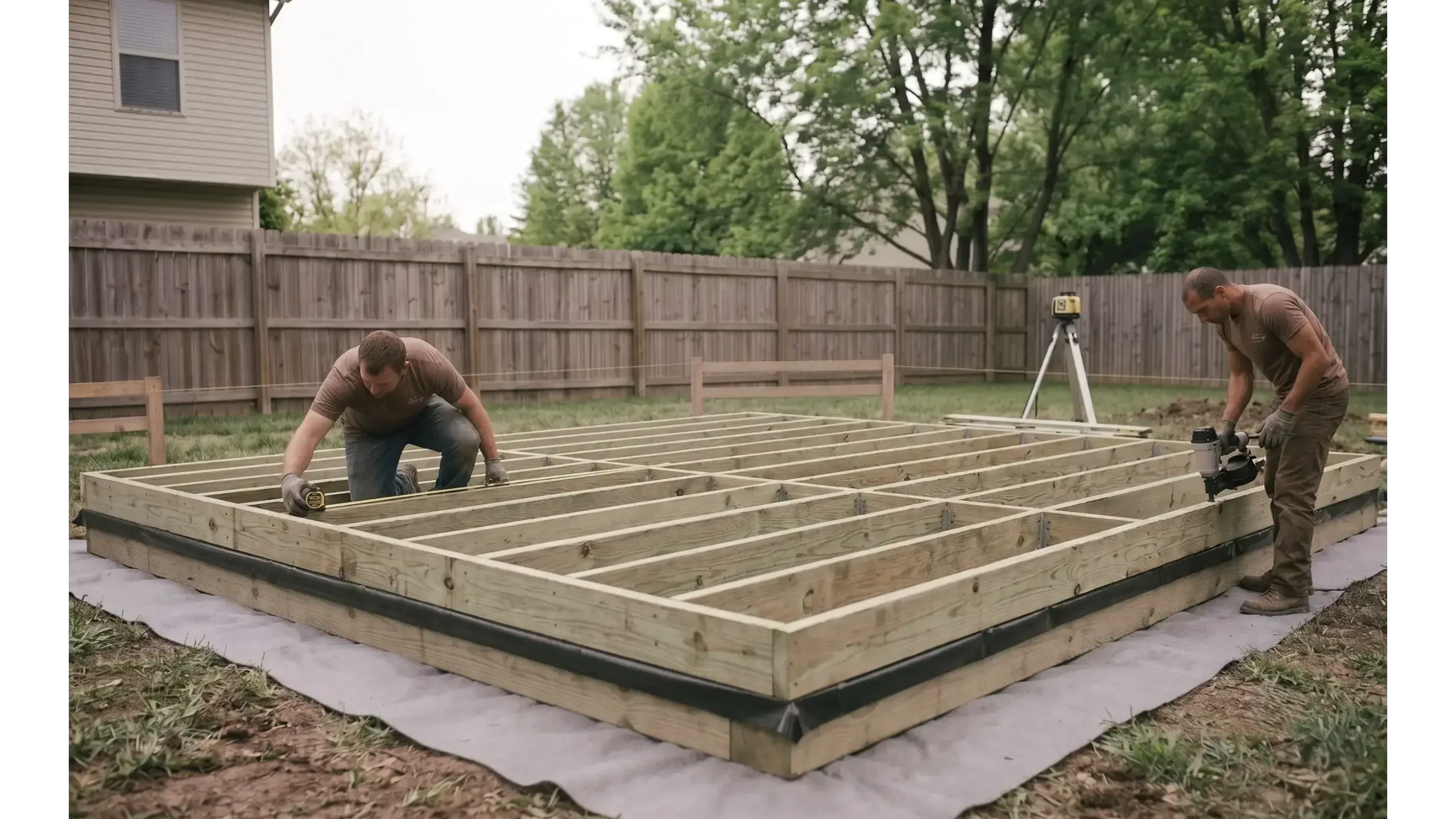

2×6 Pressure-Treated Floor Joists — Framed 16 Inches On Center With Blocking

What Happens

The floor system is framed with 2×6 ground-contact pressure-treated joists installed at 16 inches on center. Rim joists define the outside perimeter, and the joists are laid out square to the 10×12 building footprint over the four 6×6 foundation beams.

Center blocking is installed between joists to help control twisting, improve floor stiffness, and lock the joist system together before the plywood subfloor is fastened. The floor frame is checked for squareness, consistent spacing, and solid bearing before sheathing begins.

Think of the floor joists like the ribs of the building. The foundation beams carry the load below, but the joists create the structural grid that supports the plywood subfloor, walls, stored equipment, foot traffic, and long-term use.
Field Standard
  • 2×6 ground-contact pressure-treated joists installed at 16" on center
  • Floor system framed square to the actual 10×12 building footprint
  • Rim joists installed to define and lock the floor perimeter
  • Center blocking installed to help control joist movement and improve stiffness
  • Joist layout checked for spacing, alignment, squareness, and bearing before subfloor installation

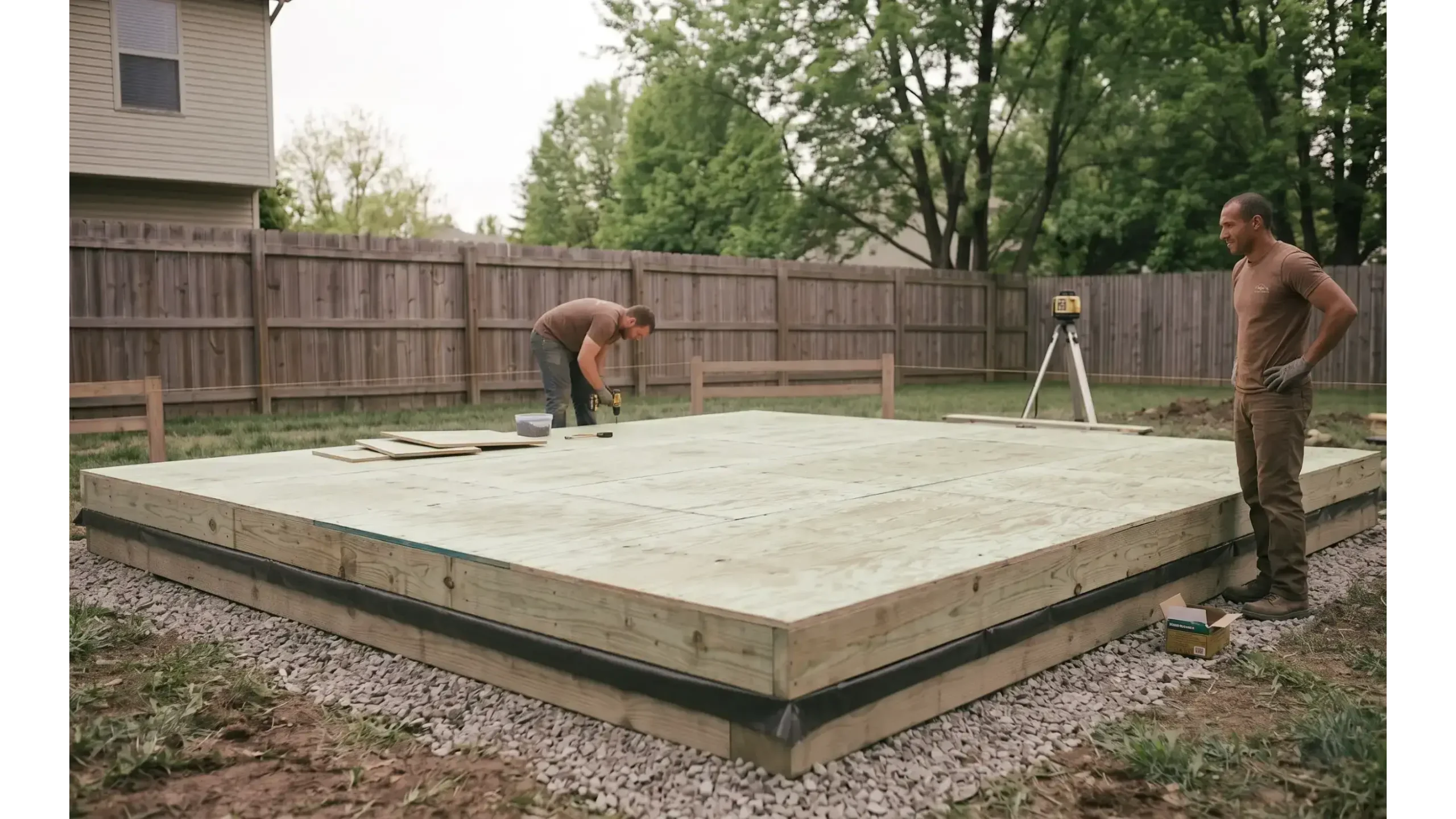

Next Step Step 13 — Completed Subfloor
Appalachian barn shed with Duratemp board and batten siding, dark trim, gambrel roof, double barn doors, side firewood shelter, and Adirondack chair.
Step 13 — Completed Subfloor

3/4" Pressure-Treated Plywood Subfloor — Framing-Ready Platform Complete

What Happens

The completed floor frame is covered with 3/4" ground-contact pressure-treated plywood. Sheets are laid out, aligned, fastened to the 2×6 floor joist system, and checked so the finished platform is solid, square, and ready for exterior wall framing.

At this point, the site preparation and foundation sequence has created a layered system: cleared ground, excavated subgrade, stabilization fabric, clean stone, moisture protection, 6×6 beams, 2×6 joists, blocking, and a structural plywood subfloor.

Think of the completed subfloor like the deck of a ship. Everything above it depends on the platform being flat, solid, square, and properly supported. Once the walls go up, correcting a weak or uneven floor system becomes difficult and expensive.
Field Standard
  • 3/4" ground-contact pressure-treated plywood installed over the completed floor joist system
  • Plywood sheets aligned and fastened to the 2×6 joists and rim framing
  • Floor platform checked for solid bearing, squareness, and stiffness
  • Subfloor installed only after beam and joist layout are confirmed
  • Finished platform prepared for exterior wall framing
Foundation Sequence Complete Next — Foundation Stack Summary & Final Project Note
Foundation Stack Summary

Every Layer Has A Job Before The Walls Go Up

A durable backyard structure is not supported by one product or one shortcut. It is supported by a complete sequence of site preparation, drainage, moisture control, pressure-treated structural framing, and verification before exterior walls are started.

LayerPurposeField Standard
811 Utility NotificationIdentifies underground utility risks before ground disturbance.Required before excavation, stake driving, or equipment placement.
Cleared Work ZoneRemoves organic material, debris, old structures, and surface obstructions.Nothing buried, covered, or worked around.
Layout & ElevationControls pad size, building footprint, squareness, and finish floor elevation.Stakes, flags, batter boards, and laser-verified elevation.
Excavated SubgradeRemoves sod, roots, topsoil, and unstable organic material.Minimum 6" excavation, deeper where site conditions require.
Compacted SubgradeCreates a firm, stable bearing surface below the drainage base.Soft spots corrected and compacted in overlapping passes.
Geotextile FabricSeparates clean stone from soil and helps prevent stone migration into clay.Commercial stabilization fabric with overlapped seams.
Perimeter ContainmentDefines and protects the stone pad edge.Pressure-treated containment installed before stone placement.
#57 Limestone BaseProvides drainage, bearing, and a stable open-graded stone layer.Minimum 6" clean angular stone across the prepared pad.
Consolidated StoneSeats and stabilizes the gravel base before moisture protection begins.Stone leveled, adjusted, and confirmed stable.
10-Mil Moisture BarrierSeparates ground moisture from the wood foundation system above.Overlapped and taped seams before 6×6 beams are placed.
6×6 Foundation BeamsProvides the primary structural bearing base for the floor system.Four 6×6×12' ground-contact PT beams for the 10×12 example.
2×6 Floor JoistsCreates the structural grid that supports the plywood subfloor.Ground-contact PT joists at 16" OC with rim framing and blocking.
3/4" PT SubfloorCompletes the framing-ready platform for wall construction.Fastened to the verified joist system after beam and framing layout are confirmed.
Final Project Note

The Foundation Is Not An Afterthought. It Is The First Quality Decision.

Site preparation controls drainage, bearing, moisture, access, and long-term floor performance. A premium shed, studio, workshop, garden building, or pool house should not begin with a shortcut under the floor.

The goal is simple: prepare the site properly before the visible building work begins, so the structure above has a stable, dry, square, and durable platform to build from.

Built On Site. Built Right. Built To Last.

Ready To Plan A Backyard Structure With The Foundation Done Right?

The Vintage Shed Company builds premium on-site backyard structures with owner-led oversight, clear construction standards, and a ground-up process designed for long-term performance in Greater Cincinnati and the surrounding Tri-State communities.

Veteran & Family Owned.
Owner-led construction judgment, premium on-site building standards, and a foundation-first approach for discerning homeowners.
